The £3.2 Billion Electricity Bill
WE Don’t Need to Pay
National Grid says its Sea Link undersea cable is essential. We say the evidence doesn't support that and there are far cheaper options that do the same job with far less damage.
Sea Link was approved. The case for it still doesn’t hold up.
The case National Grid put forward is weaker now than when it started. Below we explain why, and what happens next.
The original reason has largely gone

Sea Link was originally justified as the way to move up to 2,000 MW of power out of the Sizewell area in Suffolk. That need has shrunk to just 352 MW.
The main reason is that Nautilus, a 1,400 MW interconnector to Belgium, was moved from Suffolk to the Isle of Grain in Kent in November 2024. Even the remaining 352 MW shortfall would not appear until the late 2030s at the earliest. It also depends on other projects going ahead, including LionLink, a proposed link to the Netherlands that hasn’t been approved yet and may be built elsewhere or not at all.
A 2,000 MW subsea cable with converter stations at each end is far too big for a possible 352 MW problem more than a decade away. It also costs over £3 billion and rising, which is paid for through all our electricity bills.
National Grid keeps changing its story
Once the Suffolk argument fell away, National Grid offered new reasons. None of them stand up.
“Government reports say Sea Link is critical.” The 2024 Clean Power 2030 reports said Sea Link was needed to connect two offshore wind farms, Five Estuaries and Rampion 2. The Government has since approved both wind farms without Sea Link. Neither decision letter says Sea Link is required. National Grid took part in both examinations and never argued that it was.
“Ofgem’s early funding proves it’s needed.” Ofgem approved £1.2 billion of early construction funding in November 2025. Ofgem itself has said this approval “is also not a relevant consideration or predeterminant of the DCO approval process.” Using the funding as proof of need is circular reasoning.
“The network needs it to fix bottlenecks.” At the two East Anglian boundaries (EC5 and LE1), there’s no shortfall left once you count the upgrades already planned, such as Norwich to Tilbury and Bramford to Twinstead.
A cheaper alternative that does the whole job
Two overhead line upgrades would solve both problems:

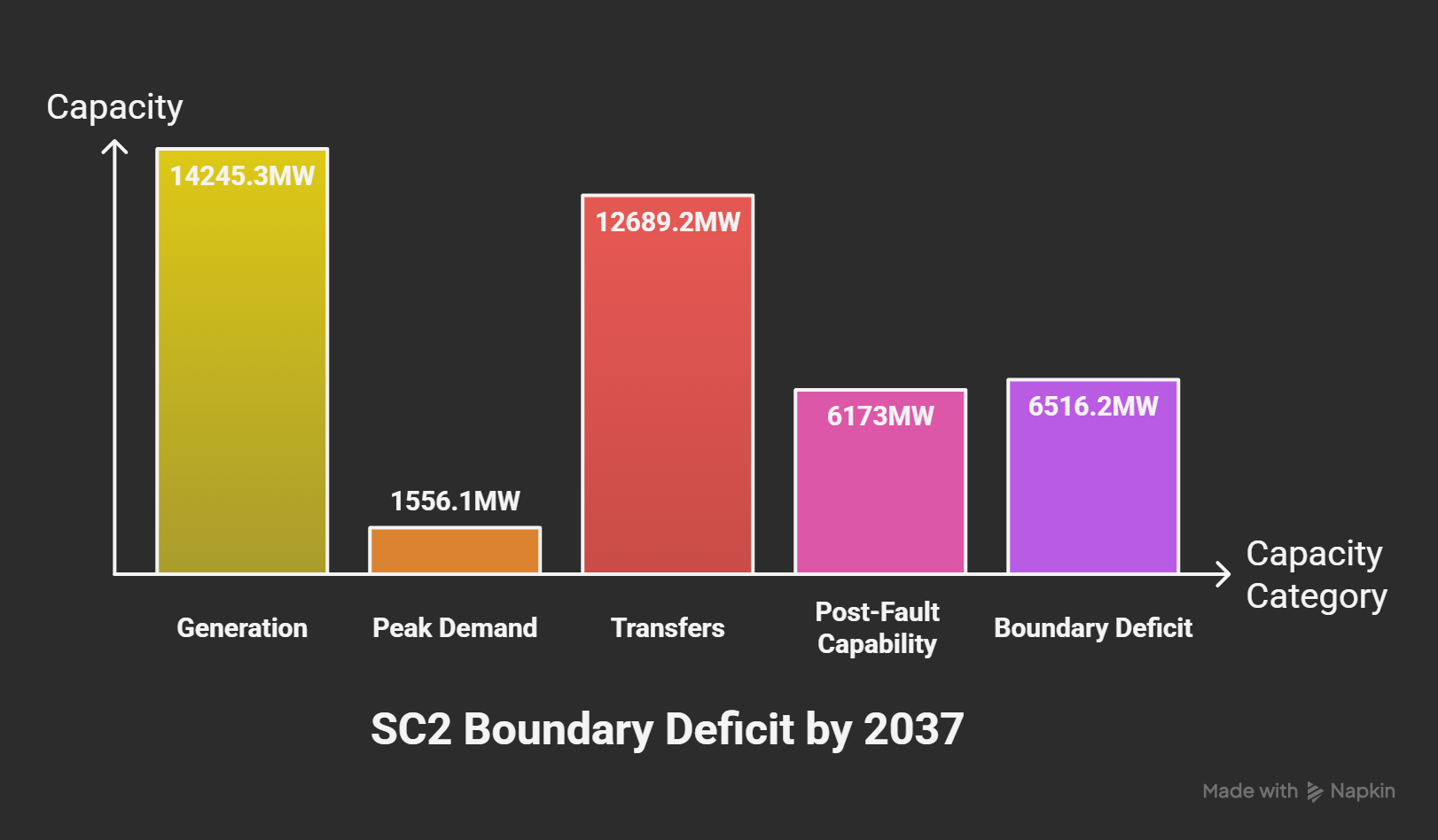

Kent: a 400 kV line between Canterbury North and Kemsley for roughly £90 million. Would fix the entire 6,516 MW Kent shortfall and add resilience towards London, where the power is needed. National Grid has already studied this option itself, under the name “CAKE”.
Suffolk: a 400 kV double-circuit between Sizewell and Bramford, about 55 km, for roughly £170 million.
That comes to around £260 million against more than £3 billion. It meets the safety rules and links up with upgrades already planned.
Other measures could help further. These include reconductoring existing lines to carry more power, intertrip services, battery storage, and running interconnectors to export when Britain has surplus power.
NESO’s own Summer Outlook (April 2026) points to growing periods of surplus generation, not shortage.
A process that raises questions
National Grid signed major supply contracts in December 2025, while the independent examination was still running. That looked like it took the outcome for granted.
Big changes such as the Nautilus move weren’t reflected in a revised need case.
National Grid companies are behind several linked projects, if they go ahead at all.
